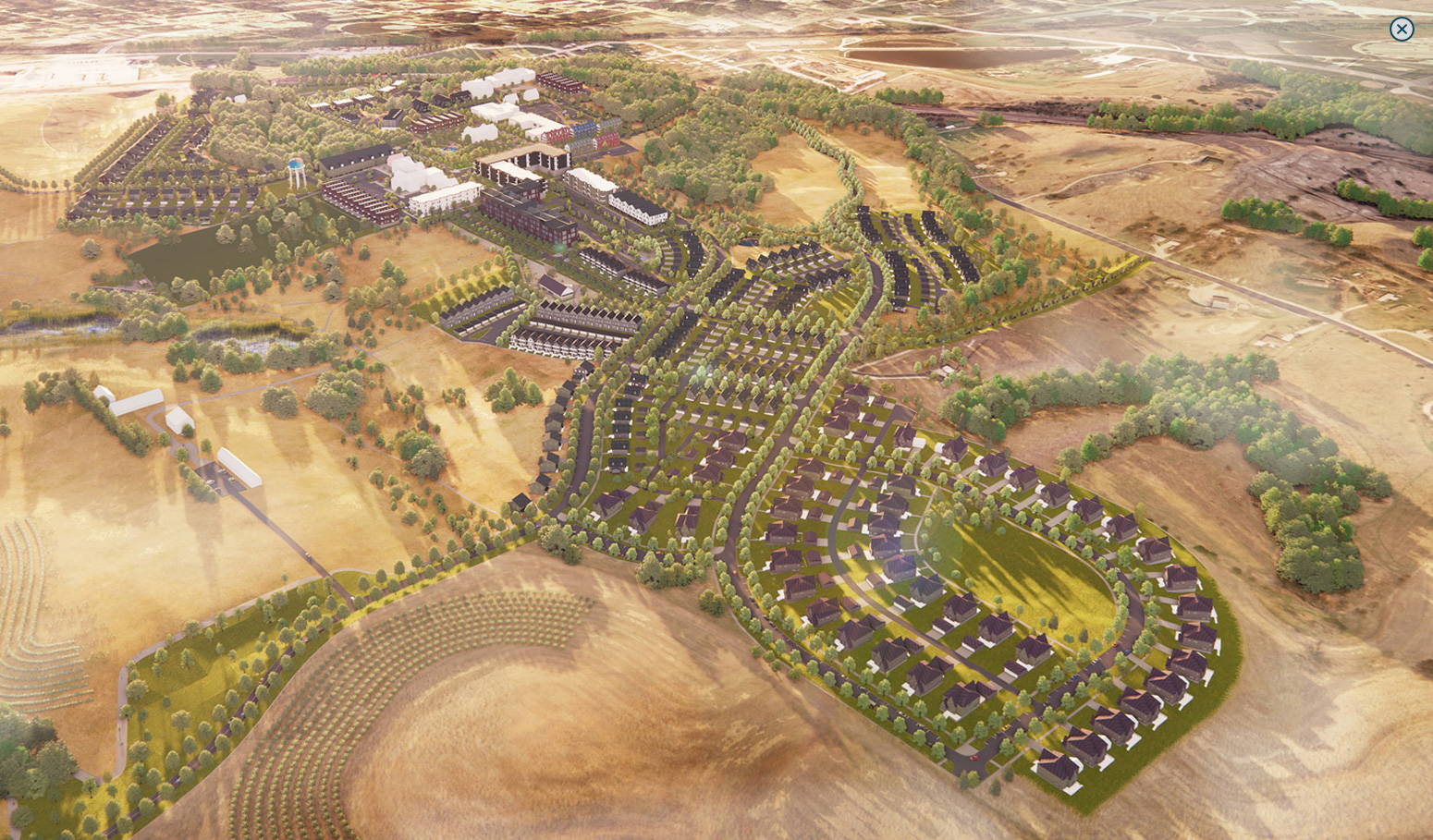

The Glenwood Resource Center campus redevelopment project is a vision for a new pedestrian-oriented, mixed-use neighborhood. The neighborhood will be a vibrant urban area with green space and amenities. A master redevelopment plan has been established to:
- Identify opportunities for building preservation and redevelopment
- Create parcels for the development of multiple housing types
- Consider cultural resources and sensitivities
- Define opportunities for improved access
- Promote economic synergies
- Provide a roadmap for sustained growth
Building Momentum
Since finalizing the redevelopment plan under the Iowa Economic Development Authority and in collaboration with other state, regional, and community stakeholders, efforts have begun to bring the vision of the former Glenwood Resource Center campus to life. Since then:
- Glenwood Redevelopment Corporation (GRC) was established as a 501(c)3 nonprofit organization and took possession of the main campus site from the State of Iowa in April 2025.
- Iowa Department of Transportation has partnered with GRC to provide access to the site via new roadways off of U.S. Highway 34 (US-34). Construction is anticipated to start in spring 2026.
- The State of Iowa has provided funding to support site improvements to prepare the site for redevelopment.
- Buildings are being decommissioned, and new utilities have been extended from the public utility system to Glen Haven nursing home and the Glenwood Community School District administration building.
About Glenwood Redevelopment Corporation
The Glenwood Redevelopment Corporation (GRC) was established in 2025 to guide the ongoing effort to redevelop the site. GRC is a non-profit organization that has been established to oversee an initial phase of site improvements and future redevelopment of the former Glenwood Resource Center. The organization is made up of volunteer board members:
- Larry Winum
- Mark Norman
- Mark Lincoln
- Richard Crouch
- Tom Hoogestraat
- Angie Winquist
- Doug Bisson

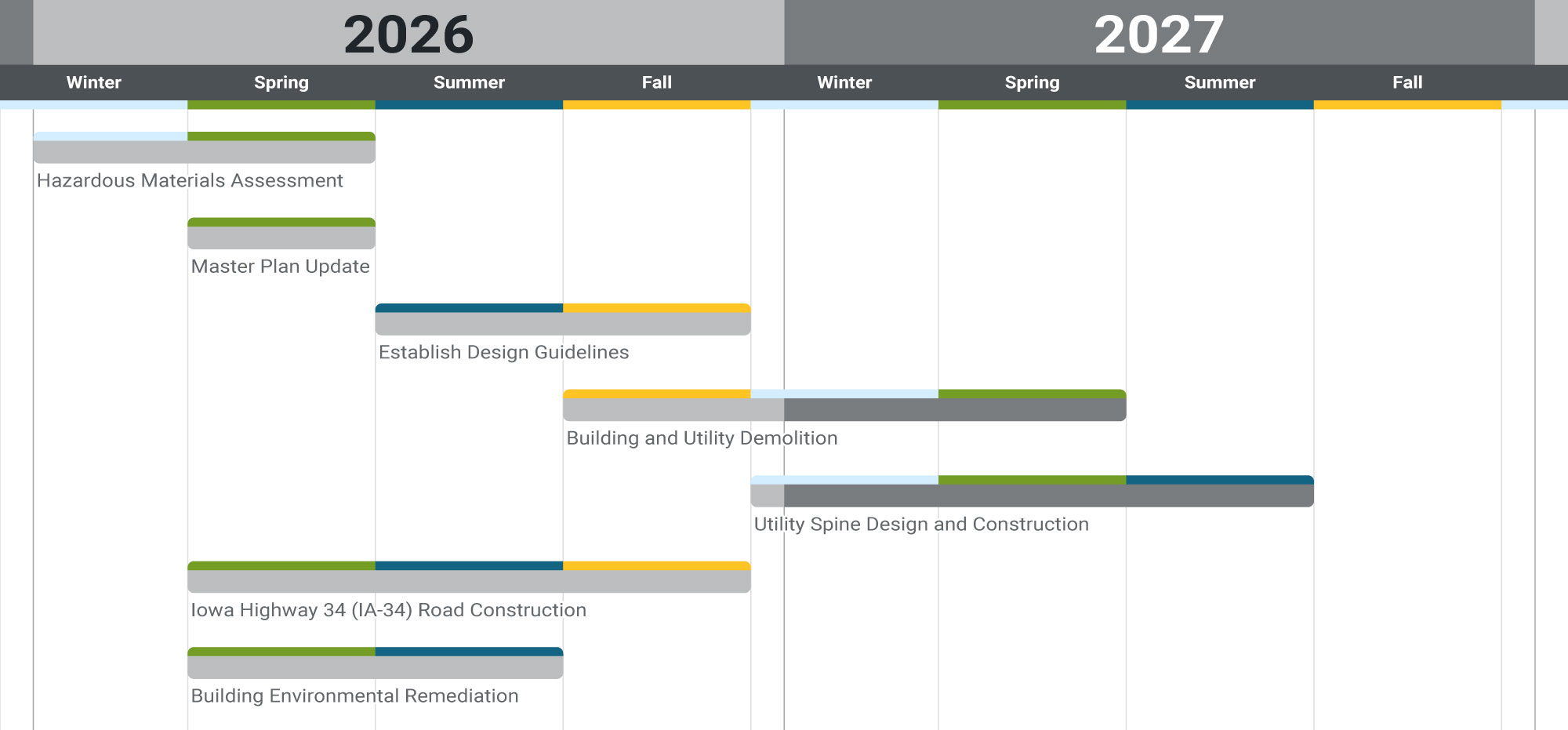

Anticipated Redevelopment Schedule

- Hazardous Materials Assessment - Winter and Spring 2026
- Master Plan Update - Spring 2026
- Building Environmental Remediation - Spring to Summer 2026
- Iowa Highway 34 Road Construction - Spring to Fall 2026
- Establish Design Guidelines - Summer to Fall 2026
- Building and Utility Demolition - Fall 2026 to Spring 2027
- Utility Spine Design and Construction - Winter to Summer 2027
Complete
- Extension of public utilities to Glen Haven and Glenwood Community School District administration building
- Onboarding of engineer and master developer
Read the Master Redevelopment Plan
More than a year of planning, research, and public engagement helped guide the Glenwood Resource Center Redevelopment Plan that provides a vision for the future of the site. Read the full plan here.
Efforts to update the master plan to account for site constraints and conditions are beginning this fall to further shape the vision for the site.
